Upper Clutha Wastewater Conveyance Scheme
Project Status
Quick links

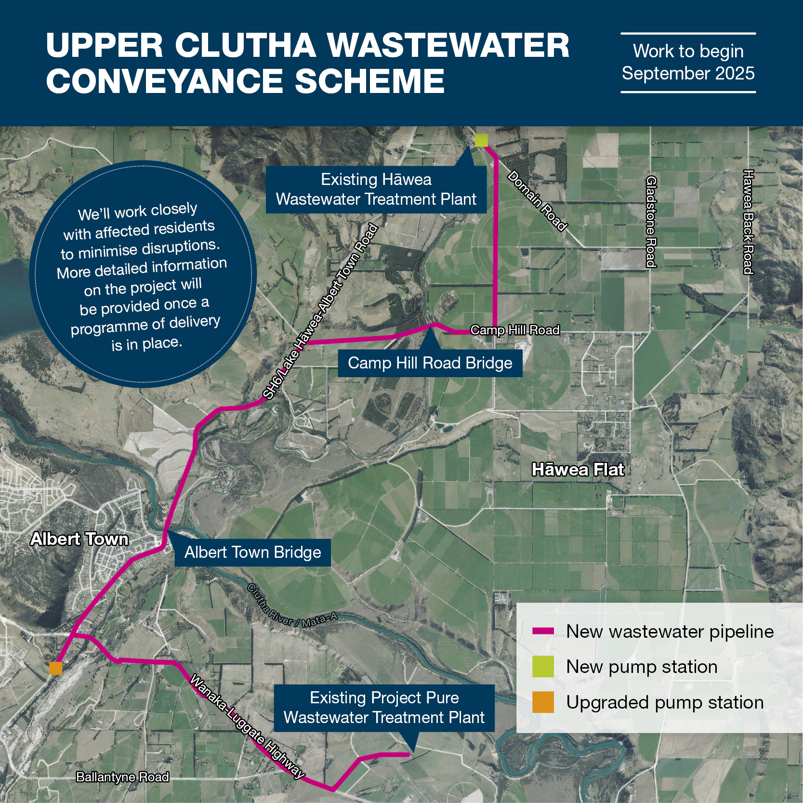

Location Map
Project scope
Updates to the wastewater network in the Upper Clutha as part of this project include:
-
Construction of a new wastewater pump station (WWPS) at Domain Road in Hāwea and a 12.5km 315mm diameter pipeline from Domain Road to existing infrastructure at the Albert Town WWPS.
-
Upgrades to the existing Riverbank Road WWPS, and construction of a 7.4km 630mm diameter pipeline rising main in the road reserve using easements from Riverbank Road WWPS to the Project Pure wastewater treatment plant (WWTP).
-
Upgrades to the Project Pure WWTP inlet.
-
Decommission the Hāwea WWTP.

What's the latest?
5 June 2026
Works on Albert Town Bridge are underway and will continue until late August / early September.
Crews will install a wastewater pipe on the underside of the bridge using a scaffolding platform. This is one of the most technically challenging components of the project to date.
There will be two daytime-only closures of the bridge.
Closure dates
Tuesday 23 – Thursday 25 June, 9.00am – 5.30pm
Monday 3 – Friday 14 August, 9.00am – 5:30pm (weekdays only)
We acknowledge Albert Town Bridge is a high-profile and high-impact closure for our communities.
Detour information
The detour will take drivers via State Highways 6 and 8A, across Luggate Red Bridge, Kane Road, Gladstone Road, and Camp Hill Road. Residents and businesses are encouraged to plan ahead. This detour will add at least an extra 15 minutes’ driving time.
Oversized or freight loads will need to travel via Deadman’s Point Bridge in Cromwell, State Highway 8A near Tarras, and Kane Road.
Other impacts at Albert Town Bridge
During the three months of work, the speed limit on the bridge will be reduced to 30km/h with bollards and speedbumps being installed at the bridge.
At all times, even when the bridge is closed to motorists, pedestrians will still be able to cross the bridge, however the footpath width will be reduced, and cyclists will need to dismount. Trail users will not be able to pass under the bridge due to scaffolding but will be able to pass with care at road level. There will also be reduced clearance under the bridge affecting river users.
-
From the existing Hāwea Wastewater Treatment Plant, south to Camp Hill Road.
Construction of the new wastewater pump station on Domain Road is progressing well. The emergency storage tanks have now been successfully installed, marking a significant milestone for the project. Work is also underway on constructing the new pump station building, with steady progress being made on site
Work to install the new pipeline from Hāwea WWPS to Camp Hill Road started in mid-May and is expected to be completed late August 2026.

-
Along Camp Hill Road and across Camp Hill Road Bridge to State Highway 6/Lake Hāwea-Albert Town Road.
As part of work in Zone 2A, we will need to use stop/go and a temporary closure of Camp Hill Bridge while crews install sections of the new wastewater pipeline in the area.
Stop/go:
Stop/go near the bridge is expected to be in place from Monday 16 March to Monday 23 March.Temporary bridge closure:
The temporary closure of Camp Hill Bridge has been delayed and will now take place on weekdays from Tuesday 7 April to Friday 17 April, between the hours of 9.00am and 6.30pm.Any traffic will need to use Kane Road, Cemetery Road, Domain Road, Capell Avenue, and SH6. Alternatively, road users will be able to use Luggate Red Bridge, SH8A, and SH6.
If you're a kayaker or surfer that uses Hāwea Wave, please be mindful of scaffolding installed beneath Camp Hill Bridge over the next two months. Headroom clearance between the water level and scaffolding will be reduced to one metre, or less at times depending on flow or river levels.
The carpark by the bridge and Hāwea Wave will remain accessible during this time.
For pedestrians and cyclists in the area, the Hāwea River Track will be open and users will be able to cross over Camp Hill Road during these works. Minor detours around the worksite may be required at times.
We're expecting work in Zone 2A to be completed in June 2026.

-
Along State Highway 6/Lake Hāwea-Albert Town Road to the northern side of Albert Town Bridge.
Work to install the new pipeline along SH6 will largely be completed under shoulder closures, but some tight sections of the road corridor may require stop/go at times as the crew moves from Dublin Bay Road towards the Albert Town Bridge.
We're expecting this work to run through until June 2026.

-
This stage of our work involves installing pipe from the Albert Town bridge through to the Mount Iron roundabout. The pipe will be installed within the road reserve alongside State Highway 6 from Kingston St and will head south from here, moving towards the Mount Iron roundabout
Construction crews will largely work under shoulder closures with possible temporary speed limits in place. In some instances, where the width of the road reserve is narrow, stop/go may be required to ensure the safety of our crews and road users.
We're expecting this work to run through until July 2026.
Full notice available below.

-
Work is underway and will continue until late August / early September 2026. Crews will install a wastewater pipe on the underside of the bridge using a scaffolding platform. This is one of the most technically challenging components of the project to date.
Scaffolding on the bridge will be installed from early June and will take approx. two weeks to erect. This will allow us to start works under the bridge. This scaffolding will be in place until September 2026.
Albert Town Bridge closures
Tuesday 23 – Thursday 25 June, 9.00am – 5.30pm
Monday 3 – Friday 14 August, 9.00am – 5:30pm (weekdays only)
Detour information
The detour will take drivers via State Highways 6 and 8A, across Luggate Red Bridge, Kane Road, Gladstone Road, and Camp Hill Road. Residents and businesses are encouraged to plan ahead. This detour will add at least an extra 15 minutes’ driving time. Traffic light sequencing on Luggate Red Bridge will be modified by NZTA as needed to help manage detour traffic and minimise delays.
Oversized or freight loads will need to travel via Deadman’s Point Bridge in Cromwell, State Highway 8A near Tarras, and Kane Road.
If you’re a pedestrian or cyclist that uses the bridge or the nearby river tracks, please be mindful of scaffolding installed on the bridge.
When crossing the Albert Town bridge, you will be required to dismount from your bike. For pedestrians and cyclists travelling on the Outlet Track and the Upper Clutha River Track, detours will be in place around the worksite. Please follow all posted signage to ensure your safety.
If you use the Clutha river / Mata-Au, please be mindful of scaffolding installed beneath the Albert Town bridge over the next four months. Headroom clearance between the water level and scaffolding will be reduced to one metre, or less at times depending on flow or river levels.
-
On Riverbank Road and through to Mount Iron Roundabout.
Zone 4 includes work to upgrade the Riverbank Road WWPS, which involves constructing a new and larger control room to operate more powerful pumps, a new wet well that holds wastewater before it is pumped to the treatment plant, and emergency storage tanks in the event the WWPS becomes inactive.
Crews will also be working to install sections of the new wastewater pipeline from the Riverbank Road WWPS through to Mount Iron Roundabout over the coming months.
What to expect:
The work will be completed in three stages as follows. The stages have been designed to reduce disruption as much as possible, while ensuring the safety of our workers.
Stage 1: Pump Station Construction work - completed
Stage 2: Pump Station construction and pipe installation - completed
Stage 3: Pump Station Construction from mid/late April - underway
Traffic lights will remain in place until construction of the upgraded WWPS is completed in approx. September this year.Why will the project take so long?
The Riverbank Road WWPS is a critical part of Wānaka’s wastewater network, and it is essential that this infrastructure continues to operate while we construct the new control room.To complete this work, controls and machinery from the existing control room will be transferred to a temporary container sitting within the road reserve, so it can continue operating while the new and larger control building is constructed. And with deep excavations and trenching to take place along and across part of Riverbank Road too, a mixture of stop/go and lane closures ensure road users and construction staff will remain as safe as possible.

-
Parts of Mount Iron Roundabout and east along SH6.
Work to install the new pipeline here is expected to require some stop/go for drivers on a small section of SH6.
We will install the pipe across SH6 to the Albert Town WWPS. This work will be undertaken during night works to minimise disruption to road users. Timing for these night works will be shared once confirmed.
We’re expecting this work to begin in late June and be completed by July.

-
From Mount Iron Roundabout and along SH6 to Cardrona River crossing.
Work to install the new pipeline is largely completed. However, the steep embankment near the Cardrona River will require stop/go and possibly night works to stablise the bank and install the pipeline.
We’re expecting this work to be completed by end June 2026.

-
From Stevenson Road, along SH6 to Cardrona River.
This work was completed in March 2026.

-
From Project Pure Wastewater Treatment Plant along Stevenson Road to SH6.
This work was completed in February 2026.

What to expect
As with any large construction project, some disruption is likely once work on these upgrades begins.
This is likely to include noise, vibration, and increased construction machinery around work sites.
Large parts of the new pipeline running from Hāwea to Project Pure will be installed on the side of State Highway 6 (SH6) or within rural road corridors, meaning we can limit most of the project’s impact with sections of temporary traffic management while these works are completed.
Other key impacts to be aware of include:
-
Bridge works: We expect increased disruption and the use of detours while installing the new pipeline on Camphill Road Bridge and Albert Town Bridge.
-
Albert Town works: Construction will be more noticeable as the project progresses through Albert Town from the bridge, and along SH6 to Mt Iron Roundabout.
Detailed updates about these works will be shared closer to the start date and well in advance, once we have more information on timing of works and the duration of any potential bridge closures from the contractor.
Timeline of works
The contract for this work was awarded to Fulton Hogan. Construction started on Thursday 25 September 2025.
We expect construction of the pipelines and pump stations to be completed by early 2027, nearly a year earlier than initially anticipated.
The Hāwea WWTP will be decommissioned over 12 – 18 months once the new pump stations and pipelines are operating.
Get updates on our progress
Keen for regular updates on how we're progressing to deliver wastewater infrastructure upgrades between Hāwea, Albert Town, Wānaka and the Project Pure WWTP?
Sign up to our newsletter below, which we'll use to share all the latest details on what to expect and any important information about construction in the area.
Read previous editions of the newsletter
Project imagery
-
630D pipes ready to be installed near Stevenson Road. Each pipe is 18 metres long and weighs just under two tonnes!
Photo 1 of 10
Photo 1 of 10
-
Pipes set out and ready to be installed near Stevenson Road.
Photo 2 of 10
Photo 2 of 10
-
Trenching underway out by Stevenson Road – 30 September
Photo 3 of 10
Photo 3 of 10
-
Sections of the new 630D pipeline installed near Stevenson Road – 30 September.
Photo 4 of 10
Photo 4 of 10
-
Sections of the new 630D pipeline installed near Stevenson Road – 30 September.
Photo 5 of 10
Photo 5 of 10
-
Pipes waiting for installation.
Photo 6 of 10
Photo 6 of 10
-
Pipes being welded together before installation.
Photo 7 of 10
Photo 7 of 10
-
Emergency storage tanks being installed at the new wastewater pump station on Domain Road in Hāwea.
Photo 8 of 10
Photo 8 of 10
-
Work starting on Riverbank Road, including a temporary control room to operate the existing pump station.
Photo 9 of 10
Photo 9 of 10
-
More of the new wastewater pipeline being installed in February.
Photo 10 of 10
Photo 10 of 10
Hāwea FAQs
-
The existing Hāwea wastewater scheme was established in 1988 and includes a wastewater treatment plant (WWTP) adjacent to the Hāwea River. Treated effluent is disposed of using a combination of irrigation and in ground disposal trenches. The scheme currently treats wastewater from the existing Hāwea township.
The plant was upgraded in 2000 and has now reached capacity. An interim upgrade of the existing plant has been implemented to enable QLDC to complete the design and construction of a long-term solution.
-
The following options were shortlisted as part of the development of the Business Case.
- Option 1 - A new wastewater treatment plant on a new site with a new sub-surface irrigation area
- Option 2 - Upgrade of the existing wastewater treatment plant with construction of new rapid infiltration basins for discharge of treated wastewater
- Option 3a - Pumping of wastewater through public and private land for treatment and disposal at Project Pure
- Option 3b - Pumping of wastewater through Albert Town for treatment and disposal at Project Pure (preferred solution)
QLDC completed a robust Multi Criteria Analysis (MCA) of the shortlisted options to determine a preferred solution for further design development. The MCA assessed each option against the following eight criteria:
- Whole of life costs
- Environmental wellbeing
- Social wellbeing
- Risk
- Consenting
- Achievability
- Future proofing
- Resilience
Option 3b was determined as the preferred solution as it provides the best balance of environmental, social, cost, and resilience benefits to the area. Importantly, it can be implemented with the least consenting risk and does not require any land acquisition or new land access agreements such as easements.
-
The new pump station at Domain Road will convey wastewater from Hāwea along a new pipeline running down SH6, through Albert Town, and then on to Project Pure WWTP, making use of existing treatment and disposal infrastructure in the Upper Clutha.
-
The existing plant was built in 1988 and QLDC has recently completed interim upgrades to enable short term compliance with consent requirements for the plant. While there are benefits to a dedicated Hāwea WWTP, construction of a new plant or upgrade of the existing plant were ruled out for two key reasons:
- The whole of life cost is estimated to be greater than the conveyance-based solution selected, due to construction costs associated with meeting the required treatment standards, and land acquisition and consenting costs.
- A Hāwea treatment plant-based solution comes with risks associated with complex consenting and/or land acquisition requirements for a new or upgraded treatment plant. As a result, there is significant risk that a treatment plant-based solution could take many years to complete or is unable to be implemented at all.
-
The infrastructure has been sized to service Hāwea and to enable future connection of Hāwea Flats and the Hāwea Campground.
-
Hāwea is currently home to an estimated 1,000 Dwelling Unit Equivalents (DUE) with around 4,000 people enjoying the township and surrounding areas on a peak day. We have assumed a high growth rate in Hāwea for the next 30 years and are currently forecasting the number of DUEs to increase to around 4,000 and the population to be around 15,000 on a peak day in this time.
-
The upgrades will provide capacity for approximately 3,000 more DUEs, which meets the growth expected to occur in the area over the next 30 years.
-
The growth projection assumptions are considered conservative and as part of the design we have confirmed the population triggers for future upgrades. Therefore, future upgrades would be required earlier if growth is faster than expected. Upgrades may include additional buffer storage, construction of a second pipeline, a local treatment plant and disposal area, or a combination of further staged upgrades.
-
The population forecast used to determine the sizing of the new system allows for full occupancy of land in Hāwea and surrounding areas enabled by the Queenstown Lakes Spatial Plan.
Wānaka FAQs
-
Currently, all of Wānaka’s wastewater is pumped out to Project Pure using the Albert Town No.2 WWPS and rising main. This includes most of southern and western Wānaka’s flows which are pumped from the Riverbank Road WWPS to the Albert Town No.2 WWPS. The Albert Town No.2 WWPS and existing rising main to Project Pure are forecast to reach capacity around 2028 - 2030.
-
The future need for a second pipeline and WWPS upgrades was identified when the first pipeline was installed in 2008, and funding for the replacement was provided for in the QLDC Long Term Plan 2021-2031. As part of this project, we assessed the pipeline alignment and WWPS upgrade options. Options included upgrading the existing Albert Town WWPS and constructing a second rising main out to Project Pure or, upgrading the existing Riverbank Road WWPS and constructing a second rising main from this WWPS out to Project Pure.
Ultimately, upgrading the Riverbank Road WWPS and constructing the rising main from this WWPS out to Project Pure was preferred. This is because this option increases network resilience by splitting Wānaka’s current and future wastewater flows between two pump stations, which will help to reduce the reliance on a single WWPS, provide the ability for either pump station to pump into either rising main if repairs and maintenance are required, and reduce the scale of upgrades needed at each pump station.
-
Upgrading the pump station includes placing a temporary control room on the site to keep this machinery running, which needs the adjacent lane closed to keep staff and drivers safe.
A temporary lane using the eastern shoulder of the road was initially considered to keep both lanes open and flowing at all times, but there are water and wastewater pipes and a manhole located there which would be at risk of being damaged by vehicles passing over the top of them.
General FAQs
-
As with any large construction project, there will be some disruption while work is undertaken. This is likely to include noise, vibration, and construction machinery around work sites.
Large parts of the new pipeline running from Hāwea to Project Pure will be installed to the side of SH6 or within rural road corridors, meaning we can limit most of the project’s impact with short sections of temporary traffic management while these works are completed.
Other key impacts to be aware of include:
- Bridge works: We expect increased disruption while installing the new pipeline on Camphill Road Bridge and Albert Town Bridge. More detailed updates will be provided to the community and any directly affected people or businesses once we have more information on timing of works and the duration of any potential bridge closures.
- Albert Town works: Construction will be more noticeable as the project progresses through Albert Town from the bridge, and along SH6 to Mt Iron Roundabout.
Council staff will ensure open communication is maintained between members of the Upper Clutha community and the contractor delivering these works, to help minimise as much disruption as possible.
-
We’ve been engaging with NZTA Waka Kotahi throughout the design process for these wastewater upgrades and can confirm the new pipeline will be attached to Albert Town Bridge. We have taken steps during design to ensure that in the event the bridge is replaced, the wastewater pipe can be realigned and attached to the new bridge.
We will continue to discuss any opportunities to integrate our respective projects with our partners at NZTA.
Any questions?
If you have any questions, please review the FAQs, or give us a call on 03 441 0499 or email services@qldc.govt.nz
